Photographic evidence5 min read

How to Photograph Building Damage for an Engineer

Owners, agents and inspectors

Take a set of photos that shows what has cracked, where it is and what someone can compare later. A close-up may show the damage clearly without letting the engineer locate it. A short, labelled sequence is usually more useful than an unsorted camera roll.

For an on-site assessment of a specific building concern, explore our forensic site inspections. An article cannot determine the cause or appropriate solution for an individual property.

Start with context, then move closer

Start with the whole wall or elevation, then take a mid-range view showing the crack and a nearby opening or corner. Finish with a close-up of the measuring point beside a readable scale.

Choose views that let someone move from the room or elevation to the particular mark. A close-up with a readable ruler can still be hard to interpret if every trace of the surrounding wall has disappeared. Additional oblique views can help show separation or distortion when they can be obtained from a safe, accessible position.

Before leaving an accessible area, check the important photos at a useful size. Make sure the damage is in focus and not hidden by glare, shadow or a finger. Keep a poor photo if it is the only record of a condition that has changed, and note its limits.

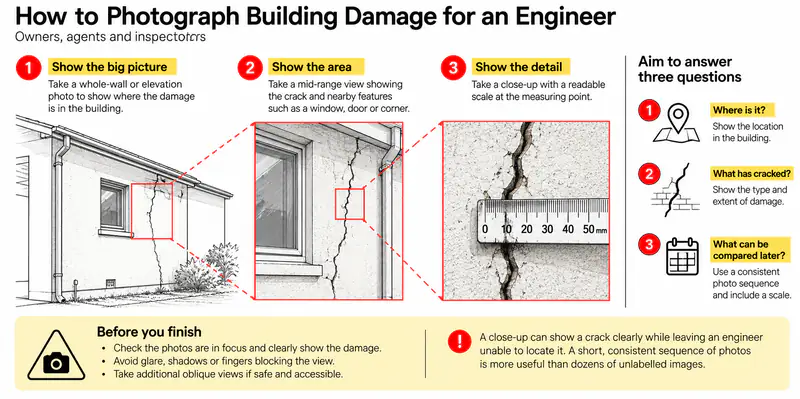

Recording building damage with context, mid-range and close-up views.
Recording building damage with context, mid-range and close-up views.
Recording building damage with context, mid-range and close-up views.

Place the scale without hiding the damage

Where practical, put the scale or reference in the same plane as the crack. Keep the scale legible and clear of the area of interest, and note what the image cannot resolve.

A photograph with a ruler is not calibrated precision monitoring. Surface texture, lighting and camera angle can affect apparent width. If the width is not reliably readable, keep the photo and say so rather than giving an invented decimal measurement.

Give the image a location and a job

Use the same issue ID in the photo log, notes and plan. 'Kitchen ceiling, beside the laundry doorway' locates the issue better than 'ceiling damage'. Record the capture date and original filename so a later caption can be traced to the actual photograph.

Caption what the photo shows and where. 'Staining beside the laundry doorway' records an observation, while 'Failed roof flashing' assumes a cause the image may not show. An arrow should identify the feature without covering it.

Repeat the setup

Keep the issue ID, date, camera position and measuring point consistent. Include enough background to relocate the point. If the surface has been filled, painted or obscured, note the change in the register.

A hypothetical pair of images taken at different angles can make a crack seem wider. Before concluding progression, compare the scale, point and image quality. Better repeat photography can clarify uncertainty, but serious associated symptoms still warrant professional attention.

Note significant differences in lighting or framing. Even two sharp photos may not be comparable if the surface was repainted, the measuring point moved or the context is missing. Keep the dates and explain those limits instead of presenting the images as a precise measurement of change.

Keep originals separate from presentation copies

Keep original files without filters or alterations. Use a separate copy for arrows and labels. The date in a filename and register is useful even when camera metadata is unavailable; do not backdate an image from recollection.

Crop, label or add arrows only to clearly marked copies. Link each crop to its uncropped original and record any brightness adjustment. Avoid filters, retouching and generated detail that change what the image appears to show.

If a sharing copy masks personal information, keep the unaltered original in the appropriate project record and identify the shared copy as edited. Ask the recipient to confirm that the files open and that the issue labels still match the notes. A reduced preview is not a substitute for the retained original.

When the first photographs are missing

State when the available photographs were taken and what had already changed through urgent work, cleaning or repair. A later image cannot be turned into a before-repair photograph by changing its filename.

If urgent work changed the area before you could photograph it, record why it could not wait and keep any contractor findings. Do not delay necessary safety work for photos. Send the engineer a selected, labelled sequence.
